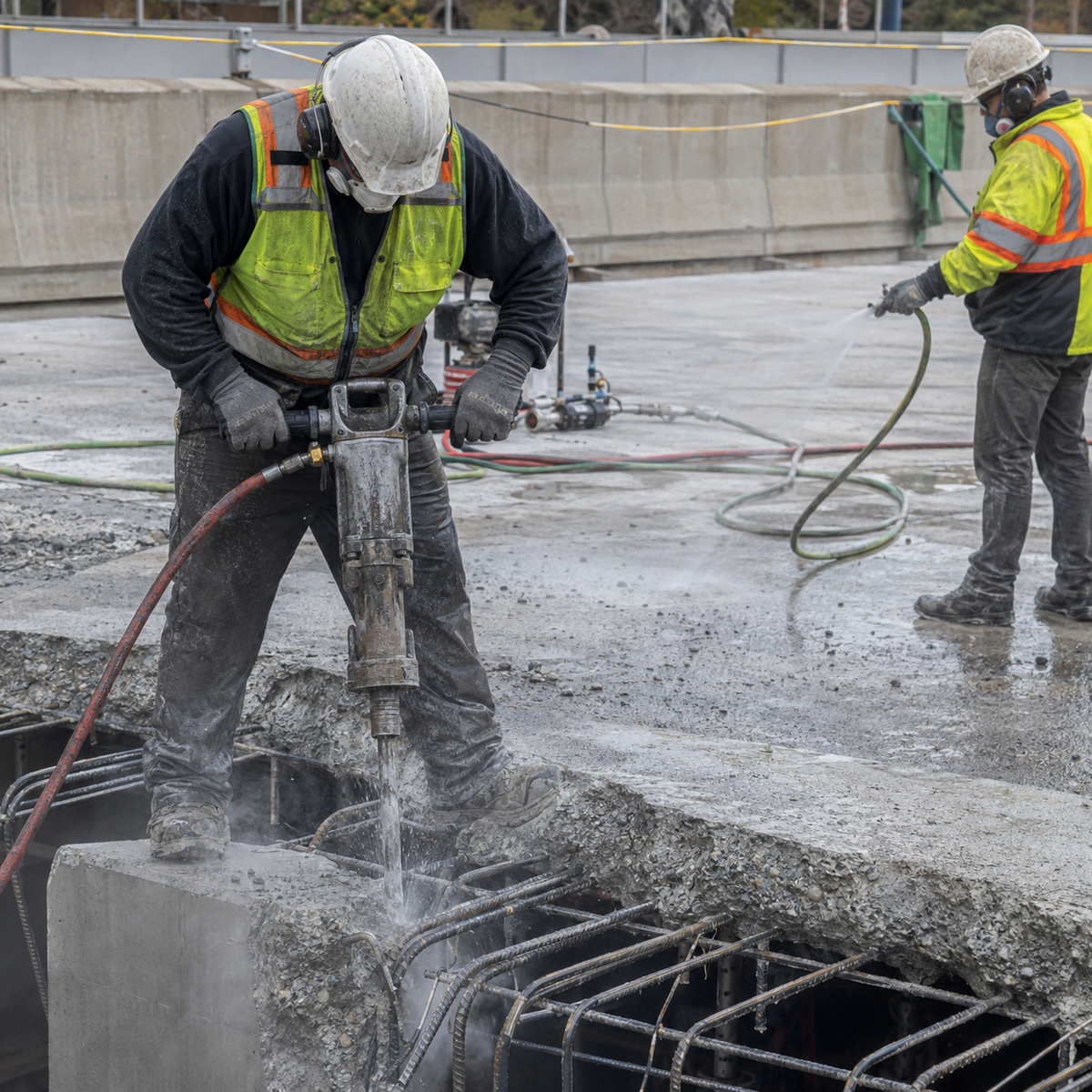

A handheld pneumatic breaker can remove reinforced concrete, but it should be treated as a concrete-fracturing tool—not a rebar-cutting tool. It works best when the removal boundary is engineered, hidden services and reinforcement are located, a free edge or relief boundary exists, dust is controlled at the point of impact, and exposed steel can be dealt with by a separate approved method. Dense reinforcement, post-tensioning, uncertain load paths, exact cut-line requirements, sensitive adjacent structures, and high-volume removal can make another method safer or more productive.
The buyer question is therefore not simply “Will the breaker hit hard enough?” The practical question is whether a handheld pneumatic breaker fits the structure, reinforcement layout, access, permitted vibration, dust-control plan, work position, compressor supply, and required production rate. This guide gives contractors and procurement teams a condition-led decision process. It does not replace a demolition plan, structural assessment, local safety rules, or the breaker manufacturer’s instructions.
Quick answer: when does a pneumatic breaker fit reinforced-concrete work?
| Job condition | Handheld pneumatic breaker fit | Planning implication |
|---|---|---|
| Accessible slab, pavement, topping, or noncritical concrete with a defined removal boundary | Often suitable | Locate reinforcement and services, create a controlled edge, and plan debris removal |
| Concrete around reinforcement that will remain | Possible with tight control | Expose steel gradually; do not use the breaker as a steel cutter or damage retained bars |
| Dense reinforcement or thick structural member | Frequently inefficient | Evaluate sawing, robotic demolition, hydrodemolition, splitting, or a mounted breaker |
| Post-tensioned or prestressed concrete | Do not proceed from appearance alone | Require specialist identification, engineering, support, and an approved sequence |
| Exact edge, shallow cover removal, or repair substrate preparation | May cause excessive overbreak or microcracking | Use a method selected for the required boundary and retained-surface quality |
| Long, repetitive, high-volume removal | May create excessive manual exposure and low output | Compare mounted or remotely operated methods and total cycle time |
Why reinforcement changes the breaking process
Plain concrete can separate once impact creates cracks and a fragment has somewhere to move. Reinforcing steel bridges those cracks and keeps broken concrete connected. The breaker may fracture the surrounding matrix while the bars continue to hold the section together. This changes the work in four ways:
- fragments do not release as soon as the concrete cracks;
- the chisel can become trapped between concrete and steel;
- impact can bend, nick, debond, or expose steel that was intended to remain;
- unsupported pieces can behave unpredictably after the last concrete or bar connection is removed.
Reinforcement is not the only hidden condition. Embedded conduits, anchors, sleeves, water lines, electrical services, and post-tensioning tendons can change a routine breaking task into a high-consequence intervention. The work package must identify what is present and what must remain before the trigger is opened.
Start with an engineering and utility survey
For structural demolition, the structure and its surroundings must be assessed by competent personnel before work begins. OSHA’s demolition guidance requires an engineering survey before demolition operations so that framing, floors, walls, adjacent structures, equipment needs, and collapse hazards can be evaluated. Local requirements differ, but the planning principle is universal: the breaker operator should not be discovering the load path while removing it.
The pre-work review should establish:
- the exact removal boundary and the concrete that must remain;
- whether the element is structural, supported, suspended, cantilevered, prestressed, or post-tensioned;
- rebar direction, spacing, cover, congestion, laps, anchors, and any steel to be preserved;
- embedded utilities, sleeves, conduits, fixings, and exclusion zones;
- temporary works, shoring, lifting points, fragment size, and debris route;
- permitted noise, vibration, water use, runoff, access, and working hours;
- the approved method for cutting or retaining exposed reinforcement.
A rebar locator or ground-penetrating radar can support the survey, but its output must be interpreted within the project’s engineering and verification procedure. Scanning does not by itself prove that every tendon, conduit, or embedded item has been found.
Create a release path instead of hammering an unbounded area
A breaker is most productive when cracked concrete can move into a free space. Starting in the middle of a large, fully supported slab can consume impact energy without releasing manageable pieces. A planned free edge, opening, saw-cut boundary, construction joint, or previously removed strip gives fractured material somewhere to go and helps control the size of fragments.
Work from the approved boundary toward the retained concrete. Keep the tool aligned so the chisel fractures concrete rather than prying against reinforcement. Clear loose fragments often enough to see the actual interface. Do not use the breaker body or chisel as a lever, and do not drive the chisel deeper simply because the concrete has stopped releasing.
What should happen when the chisel reaches rebar?
Stop and reassess. A pneumatic breaker chisel is designed to transfer impact into the material being fractured. It is not a substitute for a bar cutter, saw, shear, torch, or other steel-removal method authorized by the demolition plan. Hammering directly on a bar can damage the chisel, transmit uncontrolled vibration, deform retained reinforcement, or wedge the tool.
- Release the trigger and stabilize the breaker.
- If the chisel is binding or any inspection is required, close and isolate the air supply and bleed stored pressure according to the manufacturer’s procedure.
- Remove loose concrete using the approved sequence so the reinforcement and remaining connections are visible.
- Confirm whether each bar must remain, be spliced, or be cut.
- Use the separately approved steel-cutting or retention method, with the section supported and the release sequence controlled.
- Inspect the chisel, retainer, and shank before returning the breaker to service.
Never pull, twist, or lever aggressively on a pressurized breaker to free a stuck chisel. If the reinforcement is moving, the supported fragment is shifting, or the retained concrete begins cracking outside the boundary, stop the operation and escalate.
Control silica dust at the impact point
Breaking concrete can release respirable crystalline silica. NIOSH testing found that a properly configured water-spray attachment at a jackhammer’s impact point substantially reduced dust exposure under the tested conditions. OSHA’s construction guidance likewise recognizes a continuous stream or spray of water at the point of impact as a control option for jackhammers. The exact control, flow, respiratory protection, exposure assessment, and housekeeping requirements must follow the jurisdiction and site plan.
- Verify water or local-exhaust controls before breaking starts.
- Position the control at the source rather than spraying the general area after dust forms.
- Check nozzles, hoses, filters, capture shrouds, and water supply during the shift.
- Manage slurry, runoff, visibility, electrical interaction, and slip hazards.
- Do not dry sweep or use compressed air to disperse concrete dust.
- Use respiratory protection only as part of the required exposure-control program, not as a replacement for feasible engineering controls.
Manage vibration, noise, posture, and trigger time
Handheld concrete breakers can create substantial hand-arm vibration and noise. HSE guidance emphasizes selecting equipment that is suitable and not undersized for the task, maintaining it, using correct work practices, reducing grip force where practicable, and managing exposure through work planning and rotation. A blunt or damaged chisel can lengthen the task and increase avoidable exposure.
Do not convert a production target into continuous trigger time. Use the breaker manufacturer’s declared vibration data, representative site measurements where required, the actual trigger duration, and the applicable exposure rules. Plan fragment clearing, scanning, cutting, lifting, and inspection as separate tasks so one operator is not holding a vibrating tool continuously.
Check the pneumatic system under load
A breaker that sounds active can still be starved of air. Compressor capacity, simultaneous tool demand, hose internal diameter, hose length, coupling restrictions, leaks, inlet condition, and line lubrication all affect delivered performance. Static pressure at the compressor is not proof of pressure and airflow at the operating tool.
- Match delivered airflow and pressure to the exact breaker manual.
- Use the specified hose and coupling sizes across the complete air path.
- Inspect for leakage, kinks, internal hose damage, loose restraints, and contamination.
- Install and adjust lubrication equipment exactly as specified.
- Measure loaded pressure near the tool with rated equipment when diagnosing poor output.
- Do not raise compressor pressure beyond the tool’s rating to compensate for a restricted system.
If the breaker cannot release concrete after the boundary, chisel condition, technique, and air supply are confirmed, the method may be wrong for the reinforcement or structure. More pressure is not an engineering solution.
Choose the chisel for the concrete task—not for cutting steel
A point concentrates impact for initial fracture; a narrow or flat chisel can follow a boundary or remove material across a broader face. Actual suitability depends on breaker class, shank interface, retainer, concrete condition, working direction, and manufacturer approval. The chisel’s shank dimensions and collar form must match the breaker; a visually similar tool is not proof of compatibility.
For the wider selection logic, use the published guide on choosing a pneumatic breaker for concrete and rock. Do not select a chisel because its cutting edge resembles a steel tool. Reinforcement requires its own controlled cutting decision.
Method-change triggers: when a handheld breaker is no longer the right answer
| Observed condition | Why the breaker method is weak | Decision to evaluate |
|---|---|---|
| Dense rebar grid prevents fragments from releasing | Concrete breaks but remains locked together; binding and manual exposure rise | Planned sawing, larger mechanical method, or remote demolition |
| Post-tensioning, prestressing, or uncertain anchors | Stored energy and load path cannot be judged from the surface | Specialist survey and engineered sequence before disturbance |
| Retained concrete needs a precise edge or repair-quality substrate | Impact can create overbreak or damage beyond the intended boundary | Sawing, hydrodemolition, or another controlled-removal method |
| Adjacent structure or equipment has a strict vibration limit | Handheld impact is difficult to isolate from the retained asset | Lower-impact or remotely monitored method |
| Overhead or awkward-position work | Tool weight, debris, posture, and hose forces increase operator risk | Purpose-designed access, support, lighter method, or mechanization |
| Large volume and long trigger time | Manual productivity and exposure become the controlling constraints | Mounted breaker, robotic equipment, saw-and-lift, or staged removal |
Common mistakes that create damage or delay
- Assuming the breaker will cut the rebar. It may expose or bend steel, but that is not a controlled cutting method.
- Starting before scanning and structural review. Hidden tendons, utilities, anchors, or retained bars are then found by impact.
- Breaking without a release boundary. Cracked concrete stays locked in place and consumes more trigger time.
- Using the chisel as a pry bar. Side loading can damage the chisel, retainer, and front end.
- Forcing a stuck chisel while connected to air. Stored energy and unexpected movement make recovery unsafe.
- Using a blunt or mismatched chisel. The job slows while vibration exposure and interface wear increase.
- Judging air supply from compressor pressure alone. Restrictions appear when the tool is flowing air.
- Treating water spray as the complete silica plan. Control effectiveness, runoff, exposure, housekeeping, and PPE still require verification.
- Ignoring the retained structure. The removed piece may be small while the cracks or vibration consequences are not.
RFQ checklist for reinforced-concrete breaker work
Before asking a supplier to recommend a pneumatic breaker or chisel, provide:
- application: slab, pavement, wall, foundation, topping, or localized repair removal;
- concrete thickness and condition, plus photos with scale;
- reinforcement type, spacing, cover, congestion, and whether bars must remain;
- working direction, access, overhead restrictions, and available handling support;
- required removal boundary, daily volume, fragment size, and duty cycle;
- available compressor, delivered pressure and airflow, simultaneous tools, hose ID, length, and couplings;
- existing breaker model and complete chisel-shank dimensions when replacing tools;
- dust-control method, water availability, runoff restrictions, and local compliance requirements;
- noise, vibration, adjacent-asset, and working-hour constraints;
- quantity, spare chisels, packaging, destination, and required documentation.
PerfoMax’s live pneumatic picks and breakers collection is the relevant commercial route for this application. Current product status and exact interfaces must be confirmed before quotation; do not infer compatibility from a model name or image.
Frequently asked questions
Can a pneumatic breaker cut through rebar?
Do not plan on it. A breaker is used to fracture the surrounding concrete. Exposed reinforcement should be retained, released, or cut using the method authorized by the engineering and demolition plan. Directly hammering steel can damage the tool, deform retained bars, and create uncontrolled release.
Why does the chisel keep getting stuck in reinforced concrete?
The chisel may be driven into a narrow crack, trapped against a bar, side-loaded by an unsupported fragment, or working without enough free space for the concrete to move. Stop, isolate and bleed the air supply, then reassess the boundary and reinforcement before recovery.
Should concrete be wet when using a pneumatic breaker?
Water spray at the impact point can be an effective silica-dust control when correctly designed and maintained. It must be part of a complete site plan that addresses water supply, runoff, slips, electrical hazards, exposure assessment, and respiratory protection requirements.
Is a heavier breaker always better for reinforced concrete?
No. Tool weight and impact must be matched to the material, access, working direction, air supply, removal boundary, retained structure, and operator exposure. Dense reinforcement can remain the limiting condition even when impact energy increases.
When should a contractor switch from a handheld breaker?
Reconsider the method when reinforcement prevents fragment release, structural or post-tension conditions are uncertain, the retained edge must be precise, vibration limits are strict, the work position is unsafe, or required volume would create excessive manual trigger time.
Technical references
- OSHA Technical Manual—Demolition: engineering survey and planning principles
- OSHA interpretation—water delivery at the point of impact for jackhammer silica control
- NIOSH—Water Spray Control of Hazardous Dust When Breaking Concrete with a Jackhammer
- UK HSE—construction hand-arm vibration risk assessment and controls
- UK HSE—tool maintenance, work scheduling, and vibration exposure controls
Make the application boundary part of the inquiry
For a useful recommendation, send the structure type, removal boundary, reinforcement and utility information, work position, compressor and hose details, dust-control constraints, duty cycle, and photos. Request a PerfoMax technical quotation only after the site team has defined what may be removed and what must remain. The right breaker and chisel interface matter, but the reinforced-concrete condition determines whether a handheld pneumatic method is appropriate at all.
